Rocscience International Conference 2025 is going to take place in Sydney, Australia Read more

Search Results

23 - Stone Column Drainage

This tutorial introduces the Ground Improvement feature in Settle3 that allows users to specify regions where they want to improve the ground using the Stone column technique, specifically related to the drainage option.

The stone column drainage feature along with its theory is provided more in detail here: Stone column drainage.

By the end of this tutorial, you will be able to use stone columns with permeability parameters to accelerate the consolidation process with any type of load in different stages.

Topics Covered in this Tutorial:

  • Ground improvement
  • Stone columns drainage

Finished Product:

The initial/final model of this tutorial can be found in the Stone column drainage_initial.s3z, and Stone column drainage_final.s3z. All tutorial files installed with Settle3 can be accessed by selecting File > Recent Folders > Tutorials Folder from the Settle main menu.

1.0 Introduction

The model used in this tutorial is the modified version of the example in Jie Han (2012) chapter 5.3.5 Consolidation of stone columns.

Our model will consist of a 40 m wide x 18 m length load with total stress of 162 kPa. The following soil properties are shown. (𝛾 = 15 kN∕m3, Es = 1.1 MPa, kr = 3.47 × 10−9 m∕s, and kv = 1.16 × 10−9 m∕s).

We will be examining the consolidation that occurs after 1 month of construction for embankment with the stone column drainage.

2.0 Model

  1. First, open the initial file in the tutorial folder Stone column permeability_initial.s3z.

You will see the load already has been applied and soil properties defined in the file. We will check the project settings to see the model.

2.1 PROJECT SETTINGS

  1. Select Home > Project Settings Project settings icon
  2. In the General tab, make sure Boussinesq as the Stress Computation Method.
  3. Set Units for Stress as Metric, Stress as kPa and Units for Settlement as Millimeters.
  4. Under Time-dependent consolidation analysis, Time Units should be in Years and Permeability units in meters/second.
  5. These permeability units are applied to soil properties (k, cv) and also in stone column permeability.

    Project Settings

  6. In the Stages tab, there should be two stages with the first stage at initial stage, and the second stage with 0.083 years (1 month).
  7. Project Settings

  8. In the Soil Profiles tab, select the 'Depth below Ground Surface' option.

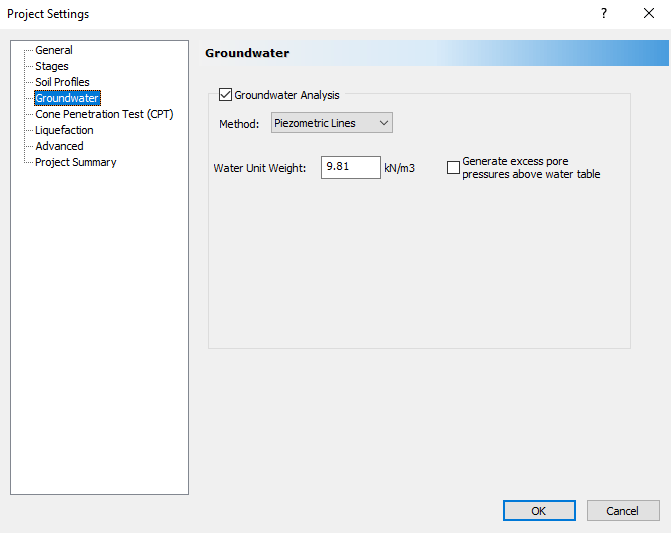

  9. In the Groundwater tab, make sure Groundwater analysis is selected. Keep the default values.
  10. Project Settings

  11. Click OK to close the dialog.

2.2 SOIL PROPERTIES

We next see the soil properties used in the model using the Soil Properties dialog.

  1. Select Soils > Define Soil Properties Soil properties icon

There should be soft clay with the properties defined below:

Soil Properties dialog

The mv is parameter converted from Elastic Modulus of 1.1 Mpa. Unit weight of soil, and permeability of soil (k) are all defined from the paper example. The example outlines there is a stiff clay layer but it's very small in thickness and does not provide the properties, so we will assume the model has homogeneous soil of soft clay.

2.3 GROUNDWATER

We also want to make sure the groundwater is in the model.

  1. Select Groundwater > Edit Piezometric line.

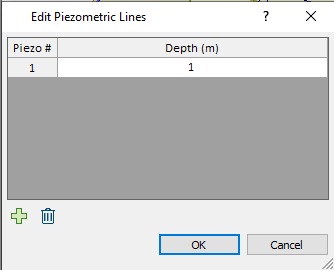

Edit Piezometric line

We have assigned groundwater 1m below the ground surface.

2.4 LOAD

  1. Right-click on the load and select Load properties.

You should see the load applied below with pressure defined from the paper which is installed in the first stage.

The 162 kPa is the load applied by the embankment in the paper: (1.8*18)*5 = 162 kPa .

 Load properties

  1. Select OK to close the dialog.

2.5 Query Point

  1. Select Query > Add Query point add query point
  2. Add a query point in the middle of the load (0.54, 29.188). You should be able to see the settlement with the added query point.

3.0 Ground Improvement

3.1 Assign Stone columns

Next, we assign stone columns to the model using the Ground improvement.

  1. Select Soils > Add Region (Ground Improvement) Add Region - Ground Improvement
  2. Select Stone columns and enter the following properties.
    • Top Depth: 0 m
    • Bottom depth: 6 m
    • Spacing: 2.4 m
    • Pattern: Square
    • Diameter: 0.8 m
    • Elastic Modulus: 30,000 kPa
    • Installation stage = initial stage (Stage 1 = 0y).

    GI_region_before_drainage

  3. Click OK.
  4. Select the region right underneath the load. Select each vertex of the load. Now we will compute the model.
  5. Click Results > Compute compute icon

You will see the results shown below. You will see around ~80mm with stone column ground improvement at the initial stage.

 Compute results

At stage 2 = 0.083 years, the maximum consolidation settlement reached is around 0.2 m without drainage.

3.2 ASSIGN STONE COLUMNS DRAINAGE

Now we will apply stone column drainage properties to the model.

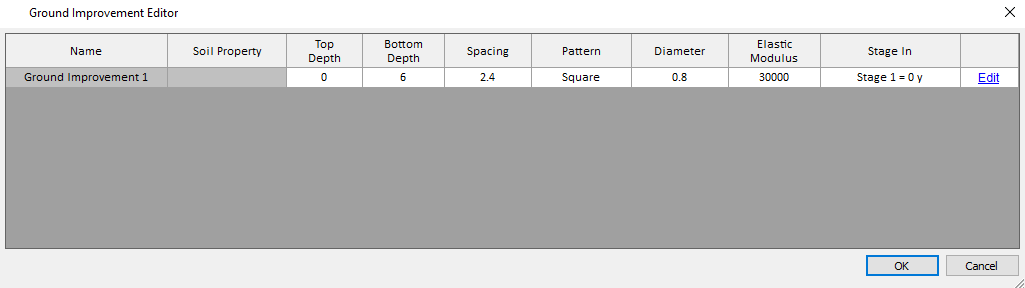

  1. Select Soils > Edit (Ground Improvement) edit ground improvement region to open the Ground Improvement Editor.
     Ground improvement Editor
  2. Click the Edit button on the ground improvement 1. Select Allow drainage.
  3. Enter the following properties:
    • ds/dc: 1
    • kr/ks: 1
    • permeability of stone columns (m/s): 3.67e-7 m/s.
    • Stage In: Stage 1 = 0 y.

    The inputs should look as the following:

    Ground Improvement Region dialog

  4. Click OK to exit the dialog.
    Now we will compute the model with the drainage option.
  5. Click Compute compute icon
  6. Select Stage 2 and see the consolidation settlement below (uncheck Soil Columns > Show Front Faces in the View Controls to better see the results):
    result_with_drainage

As you can see, the consolidation settlement has progressed much faster with the addition of drainage option in stone columns. Also note that before the drainage, the consolidated settlement after 1 month was around 0.2 m, as opposed to 0.5 m after 1 month with drainage option.

We can also see the difference in the result when the single drainage path option is enabled. Select Soil > Ground Improvement > Ground improvement region editor.

Select Edit and select the option to use the single drainage path.

Ground Improvement Region Dialog

You will see the displacement has reduced slightly after one month with a single drainage path.

Figure with Results

Thus, the drainage option provides significant improvement in process of accelerating consolidation. We will demonstrate this using the time query in the next step. Before we create the time query point, we'll modify the model so that a double drainage path is used. Unselect the use single drainage path option.

4.0 Results

4.1 TIME QUERY

Now we will add time query to see how long it takes for 95% of primary consolidation to occur.

  1. Select Query > Add Time Point add time point

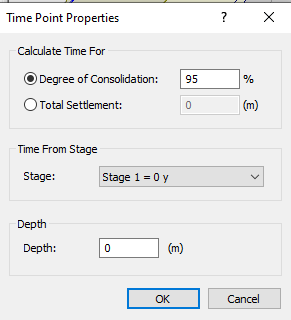

  2. Enter the following properties:
    • Degree of consolidation to reach: 95%
    • Time from Stage: Stage 1 = 0 y.
    • Depth = 0 m.

    The dialog should look as below:

    Time Point Properties

  3. Click OK.
  4. Place anywhere within the load and you will see the time query created in first stage.

With drainage:

Time Point Properties w/ drainage

In comparison, for case without drainage, you can select: Soils > Edit (Ground improvement). Simply turn off the drainage option and recompute. You will see that it takes much longer time to consolidate to 95% of consolidation as shown below.

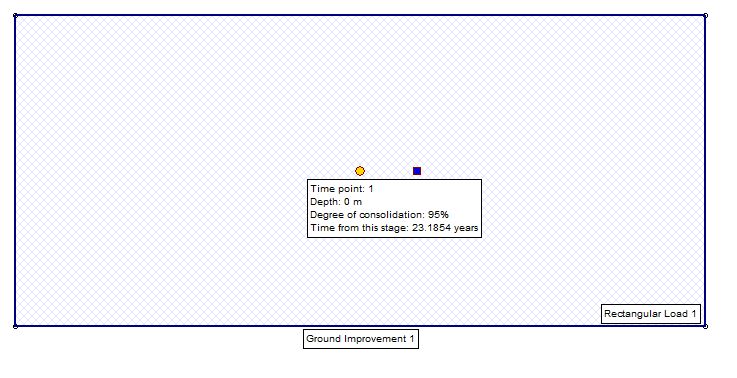

Without drainage:

Time Point Properties w/o drainage

Thus, this feature allows you to see the significant impact of accelerated consolidation by adding drainage in stone columns.

5.0 References

  1. Han, J. (2012) "Principles and practice of Ground improvements” John Wiley & Sons. ISBN 978-1-118-25991-7. ,165-167
